Construction Updates
We are looking forward to bringing this community hub and resource to life. Below are updates as we progress through construction.
November 27, 2024
See what we have been up to in the video below!
October 30, 2024
The team continues to make great progress. Accomplishments this past month include:
- Underground Utilities Installation
We have made significant progress in the installation of major underground utility lines, including domestic water, sanitary sewer, storm drain, and fire protection water. - Earthwork
Rough grading of the site is mostly complete, including the pavilion, dog park, and skate park. Finish grading will take place after utilities have been completed. - Building
The installation of 637 stone columns has been completed as a structural element for the building foundation and installation of underground electrical and plumbing is underway. - IFM/Dust Control
A temporary gravel parking lot for IFM has been installed in preparation for winter and dust control. We have strict dust control measures in place to minimize the impact on the community and the environment. This includes regularly spraying water across the construction area, and installing rumble plates for vehicles exiting the site. Our goal is to keep the site as clean and safe as possible while construction progresses.

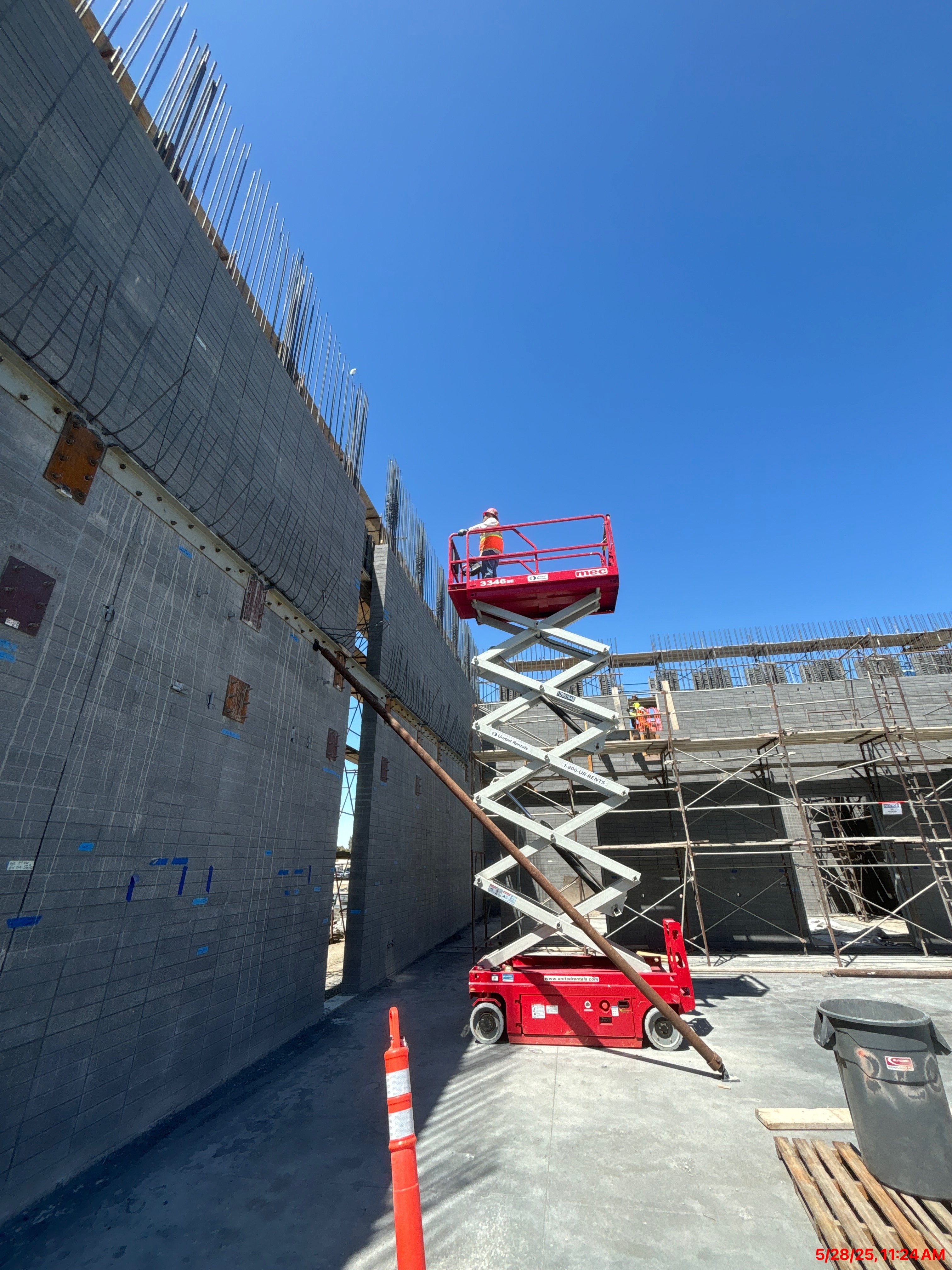

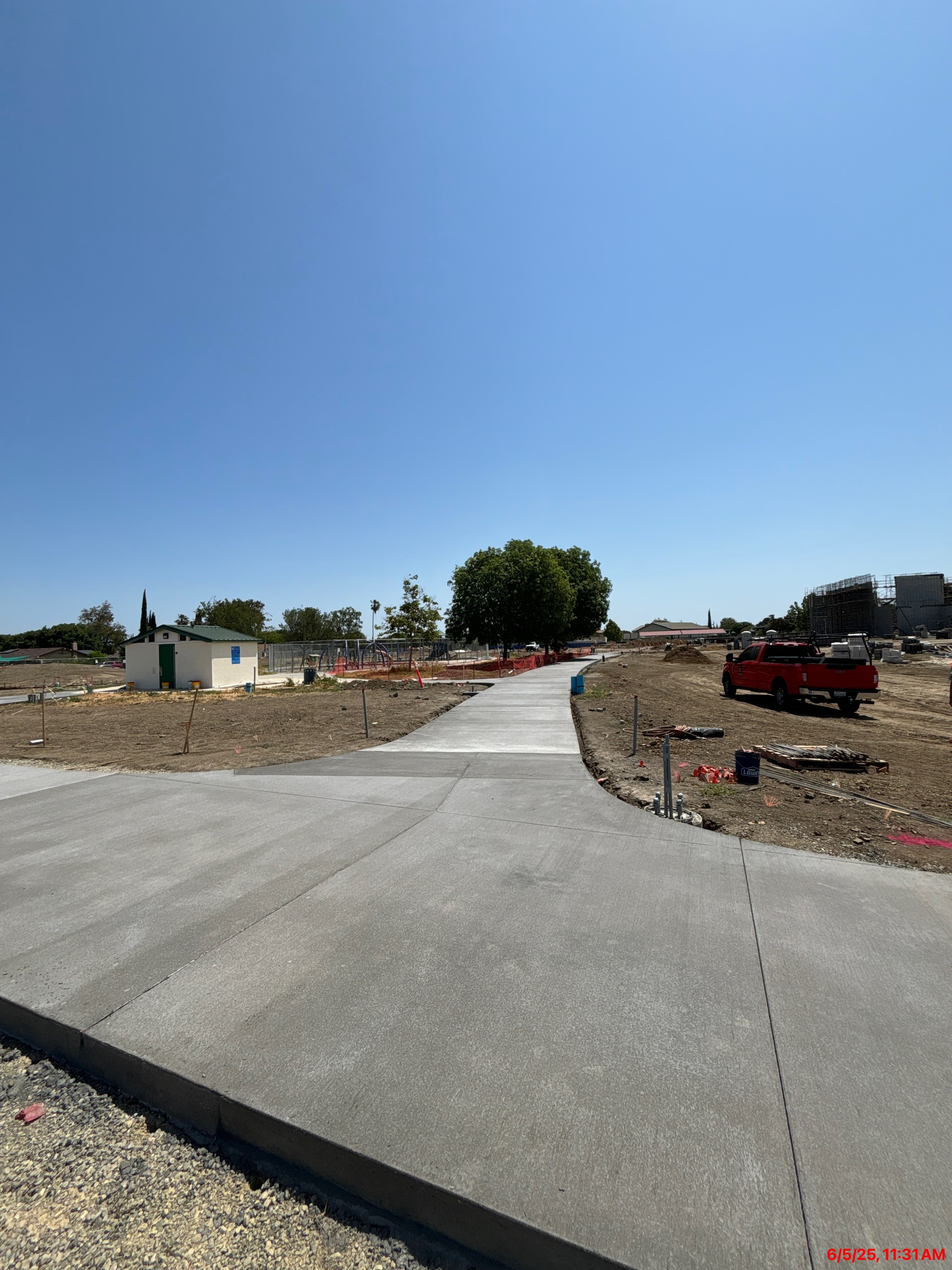

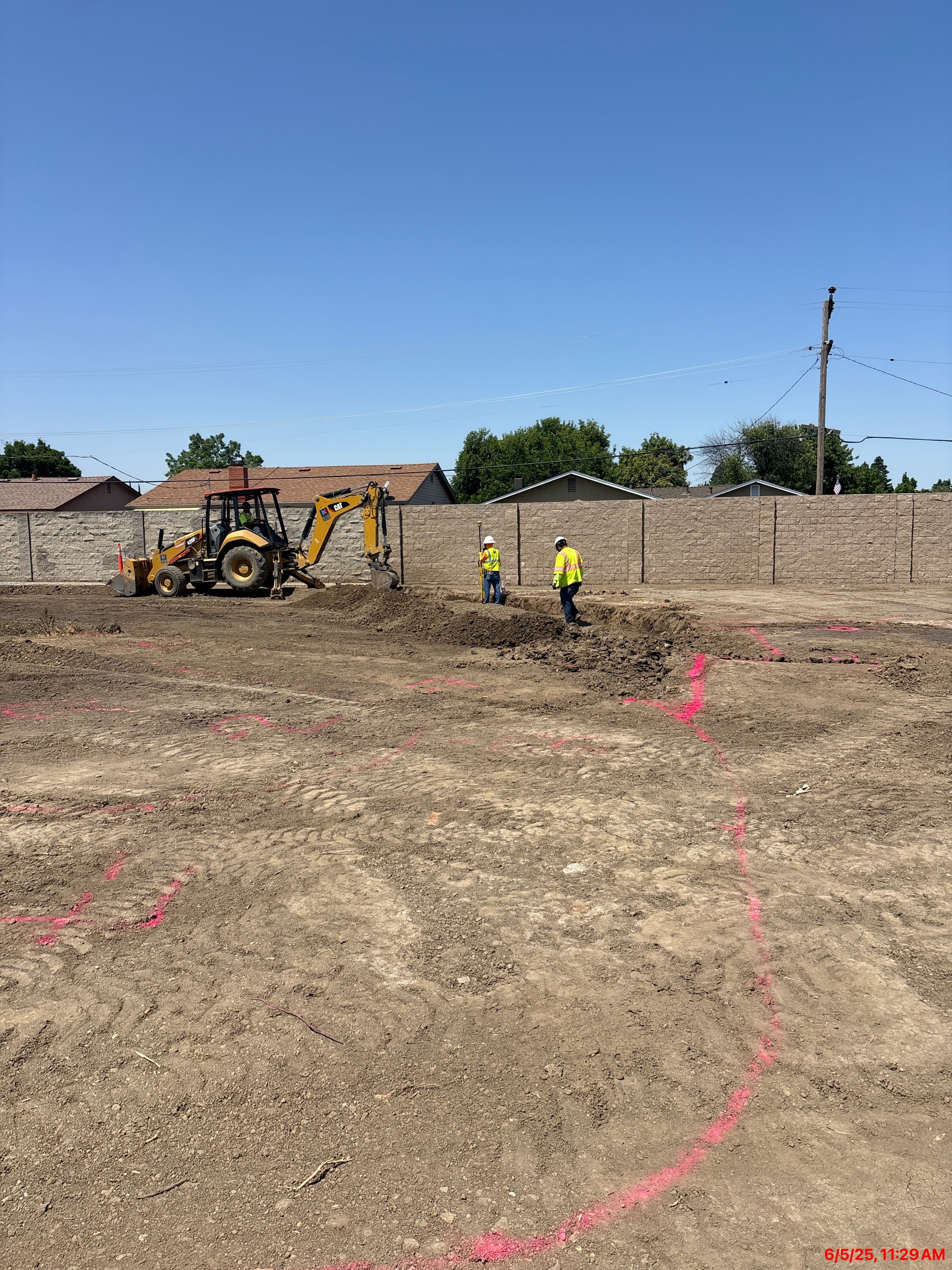

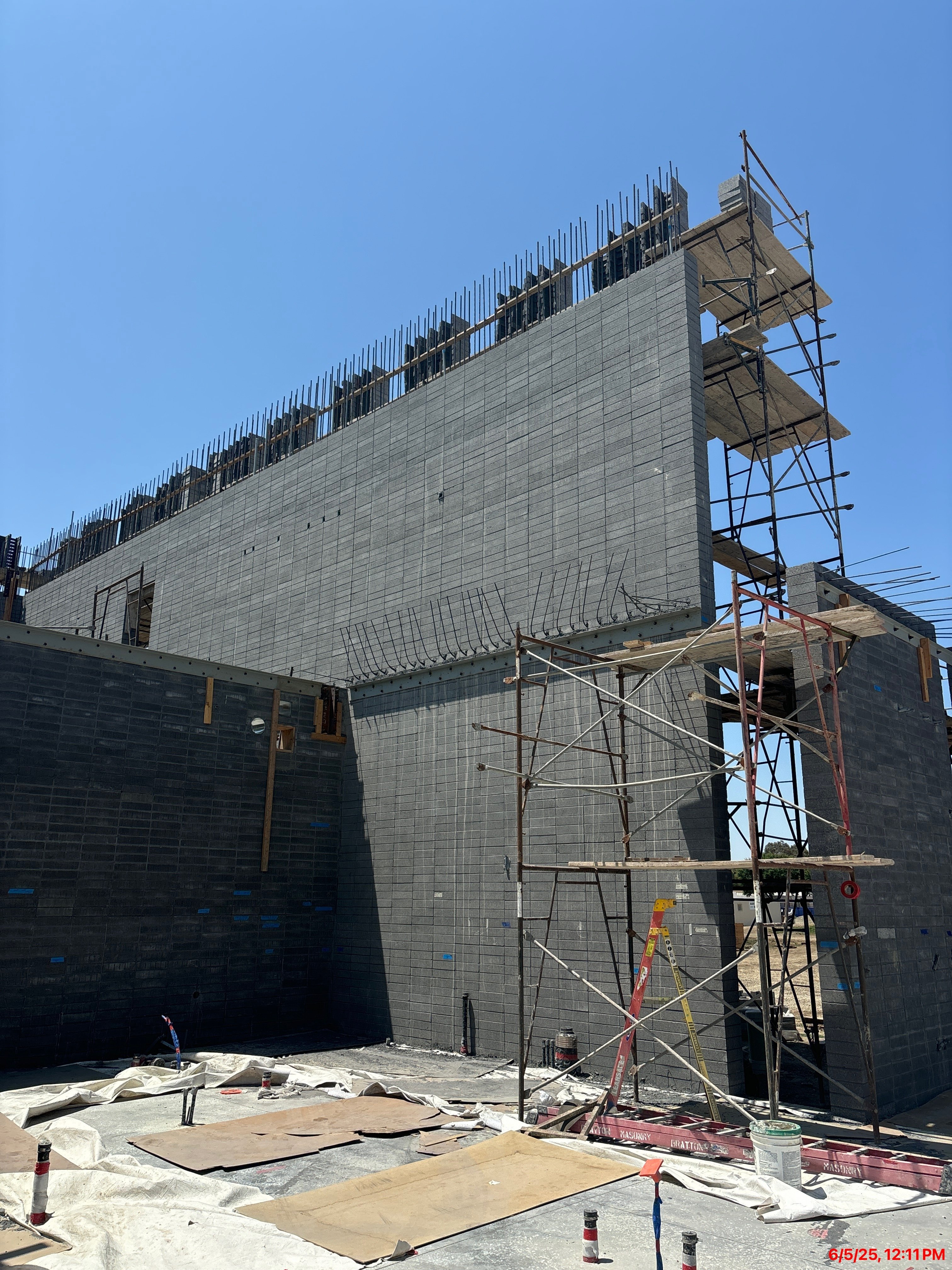

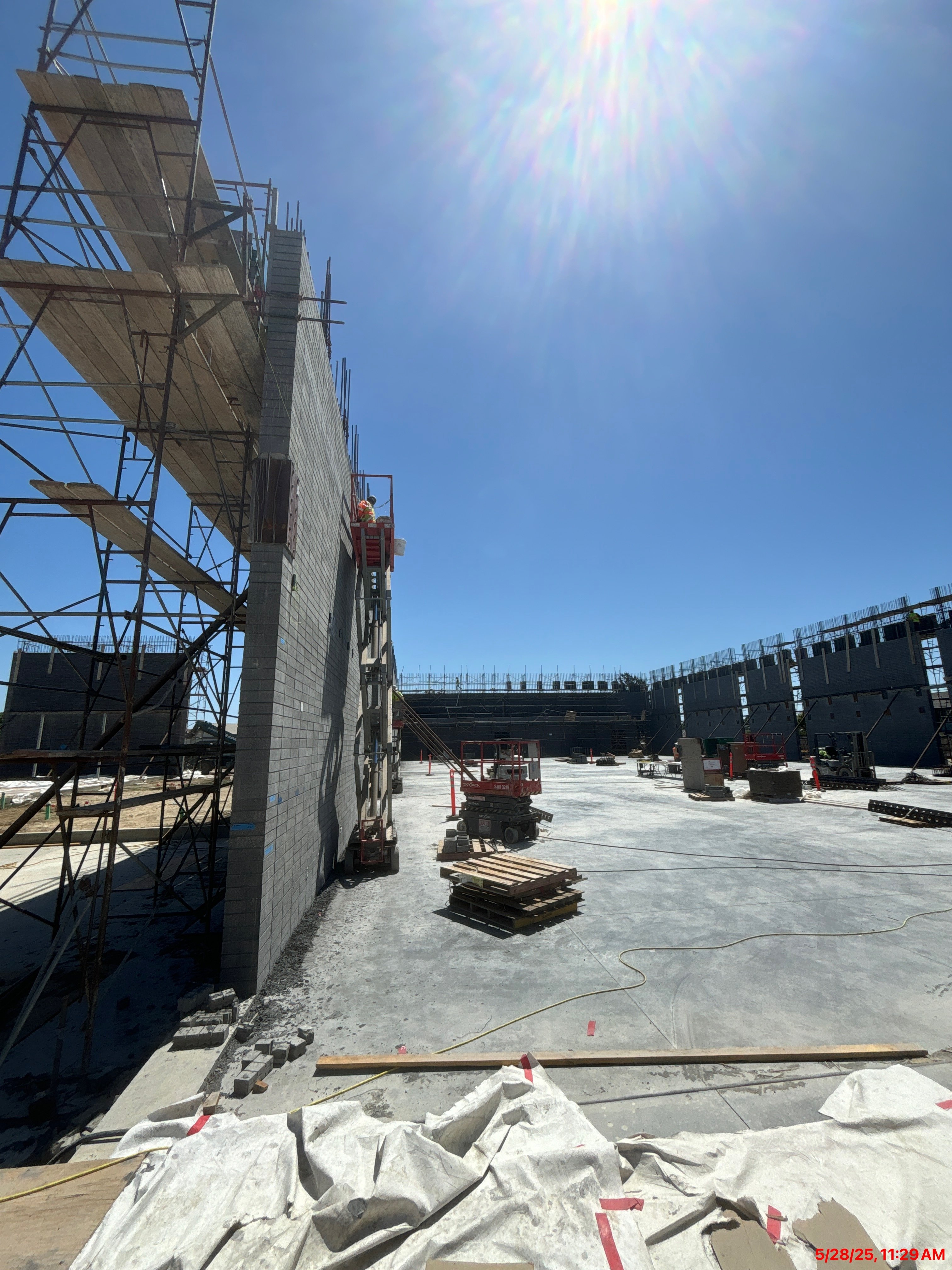

Check out the latest photos below. Click left and right arrows to view more photos.
September 27, 2024
Due to resequencing of construction activities, no work will take place Saturday, September 28th.
Construction will continue Monday-Friday working 7 am - 7 pm through the first week of October.
September 16, 2024
This past month has seen some great progress, including:
- Mobilization of trailers, fencing, and established parking.
- Start of demolition, removal of trees, removal of the skate park, removal of the dog park.
- Rough Grading and organics removal.
- Demolition of underground utilities, including removal of transite pipe.
- Start of dirt work with dust control.
Skate Park: After |
Skate Park: Before |
Basketball Court: After
|
Basketball Court: Before |
Trees: After |
Trees: Before |
Trailer Mobilization On-site |
August 19, 2024
The project has started the demolition of underground utilities, including the separation of materials such as tree roots, underground pipes and conduits. The soils improvement continues from east to west.
In the video below we can see the sheep foot roller working on soil compaction. Also visible is two water trucks that are working to maintain optimum moisture and dust control during the operations.
August 5, 2024
Please excuse our noise as we have started demolition which will continue until 8/9/2024. Check out the video below to see what is happening onsite this week.
July 22, 2024
Construction for the City of Tracy Multi-generational Recreation Center began in July 2024. The project is anticipated to last 24 months.
Future Amenities
Contact
For questions related to this project please contact Juan Bernal, Site Superintendent with Gilbane Building Company at (669) 317-7702.
Stay in the Know: Subscribe to Construction Updates
Groundbreaking News!
On Tuesday, September 17th, we celebrated the groundbreaking of Tracy's new 61,300 SF Multi-generational Recreation Center. This state-of-the-art facility is designed to serve all ages, offering versatile spaces that meet the diverse needs of our community. We are excited for the beginning of this exciting journey toward a healthier, more connected community!
Check out photos from the event below.
Design Packages
Skate Park Final Design
Click the image below to view larger.
Schematic Design
- Schematic Design Basis of Design
- Schematic Design Plans
- Schematic Design Imagery
- Schematic Design Plant Palette
Design Development
Initial Study - Mitigated Negative Declaration
Notice of Intent to Adopt an Initial Study-Mitigated Negative Declaration - Click Here
Initial Study-Mitigated Negative Declaration - Click Here
As mandated by State Law, the minimum comment period for this document was 20 (twenty) days and began on July 28, 2023 and concluded on August 16, 2023. Pursuant to Public Resources Code Section 21177, any legal challenge to the adoption of the proposed Initial Study/Mitigated Negative Declaration are limited to those issues presented to the City during the public comment period and/or during any duly noticed public hearings.
The City Council held a public hearing to adopt the Mitigated Negative Declaration on September 19, 2023 at the City Hall Council Chambers, 333 Civic Center Plaza, at 7:00 pm.
